Risk radar

Route: /org/tasks?panel=risk · Permission: View risk radar (Manage risk radar to recompute and change settings) Module: Task Management · Entry points: Tasks toolbar → Risk · task badges and Why? · Roadmap milestone chips · Project settings → Risk Radar


What this is. A daily picture of which tasks, assignees, sprints and milestones are about to slip — and, on request, AI-ranked interventions. What it is for. Catching a slip while there is still time to reassign, split, descope or extend. The problem it solves. Overdue is too late. The radar flags schedule pressure, velocity gap, stale, blocked and milestone burn before the date passes.


1. What the Risk radar is​

The radar is computed from your project's own data — due dates, remaining hours, time logged, activity, dependencies, milestones and who is assigned to what. It costs no AI credits: the signals are arithmetic, recomputed every morning by a platform job and whenever you press Recompute. AI is used only when you ask for interventions.

SignalFires whenSeverity
OverdueThe due date has passedHigh (critical if also blocked)
Schedule pressureRemaining hours exceed the working hours left before the due dateLow → high by ratio
Velocity gapAt the recent pace (hours logged over the look-back), the task lands after its due dateLow → high by overshoot
StaleIn progress with no activity for the configured number of daysMedium (high if due soon)
BlockedA predecessor is still openMedium (high if the predecessor is late)
Unassigned near dueNobody is assigned and the due date is within the due soon windowMedium
Assignee overloadedA member's remaining hours over the horizon exceed their capacity × the overload ratioLow → high by load
Milestone burnThe pace needed to finish the milestone's open tasks exceeds the recent paceLow → high by ratio
Milestone overdueThe end date has passed with open tasksHigh

Every task, assignee and milestone gets a score and a severity (none, low, medium, high, critical); the project's health is the worst milestone.

Project-scoped

The radar reads the currently selected project. With no project selected, the Tasks page shows no Risk button.


2. How the radar fits together​


3. Using the radar — step by step​

Figure 1 — The Risk radar: 1 Milestone health, 2 At-risk tasks, 3 Team load, 4 Ask AI for interventions.

Step 1 · Open the radar​

Tasks → Risk. The button carries a count of medium-and-above items, coloured by the project's health. The panel has three sections: Milestone health (cards with tasks and hours remaining, days left and burn), At-risk tasks (severity pill and signal chips — hover a chip for the value behind it and the formula), and Team load (a bar per member over the coming two weeks).

Click a task to open it. Recompute today's snapshot now refreshes the picture without sending any notification (Manage risk radar).

Step 2 · Read the badges​

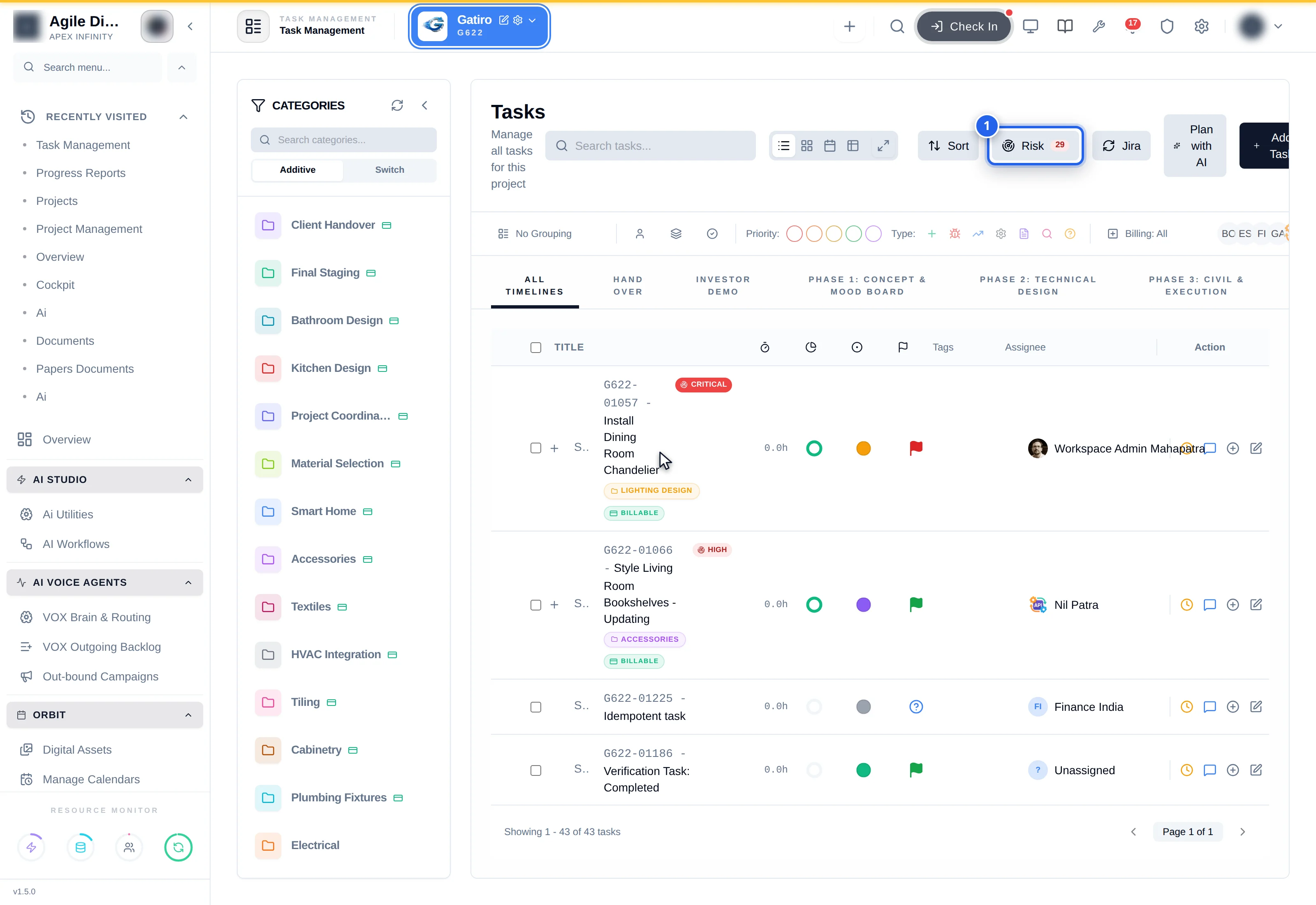

Figure 2 — Severity badges on task rows and the Risk button with its count.

At-risk tasks show a coloured badge in the list, on kanban cards, in the table's Risk column and in the task header. Why? lists the signals that fired. On the Roadmap each milestone shows a health chip; hover it for the burn figures.

Step 3 · Ask AI for interventions​

Figure 3 — AI interventions: 1 ranked list, 2 Apply.

Type optional guidance (protect the release sprint, Priya is on leave next week) and press Ask AI for interventions. You get a headline, an overall health, a short narrative, a ranked list of interventions — each naming a real task or milestone, an action (reassign, split, descope, extend, unblock, escalate), the rationale, expected impact and confidence — and a watchlist.

The advice is cached until the risk picture changes: asking again on the same day costs nothing.

Step 4 · Apply an intervention​

Every Apply goes through a confirmation and then the normal task action, with your normal permissions:

ActionWhat Apply does
ReassignChanges the assignee (needs Assign or Change Assignee)
ExtendSets the new due date (needs Edit or Change Due Date)
SplitOpens Suggest sub-tasks for that task
Descope · Unblock · EscalateAdds a comment on the task with the rationale (needs Edit)

A greyed Apply carries a tooltip naming the missing permission.

Step 5 · Tune the settings​

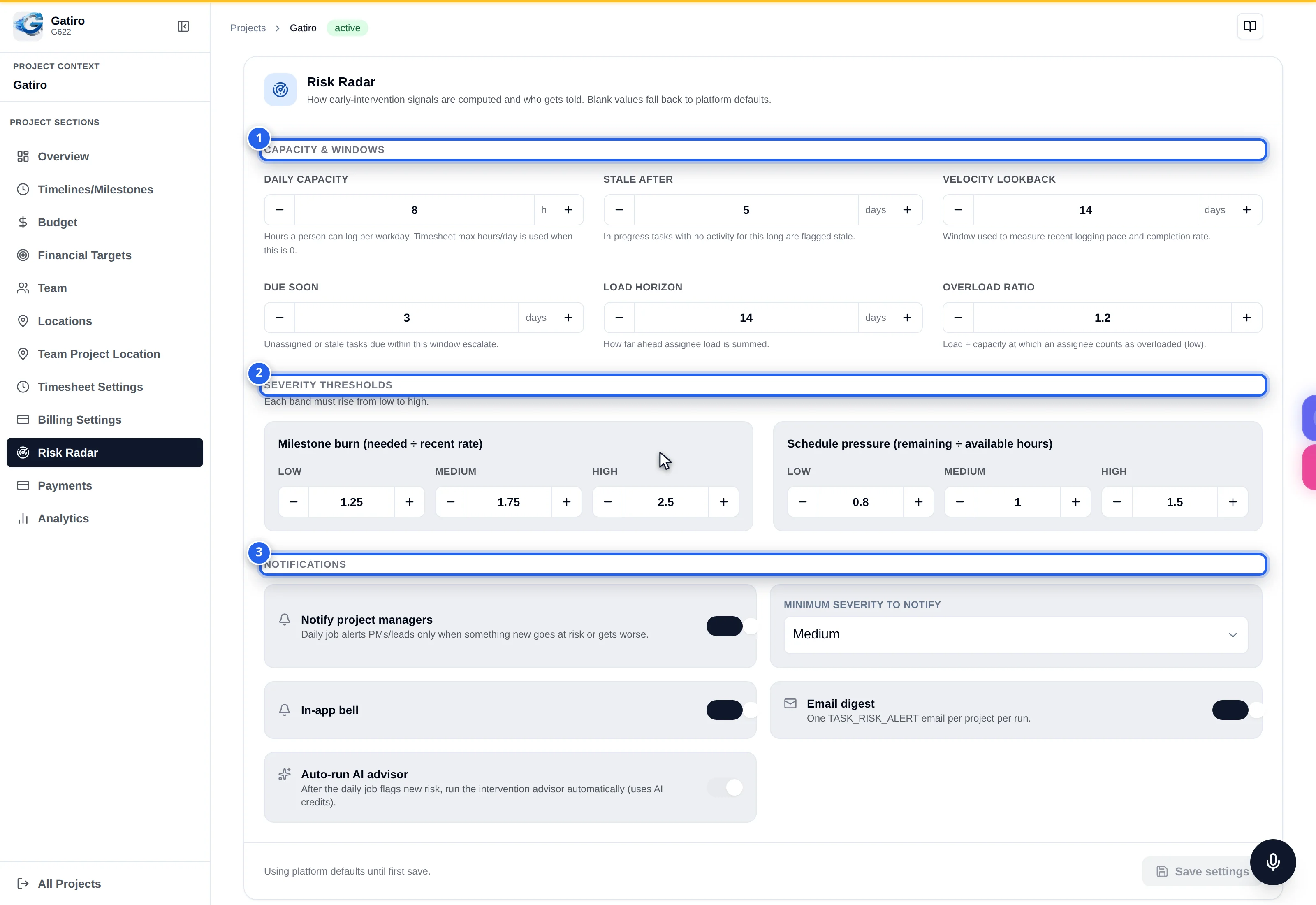

Figure 4 — Project settings → Risk Radar: 1 Capacity & windows, 2 Severity thresholds, 3 Notifications.

Project → Settings → Risk Radar (Manage risk radar).


4. Field reference​

SettingDefaultMeaning
Daily capacity8 hWorking hours per person per day
Stale after5 daysIdle days before an in-progress task is stale
Velocity lookback14 daysWindow used to measure pace
Due soon3 daysWindow for unassigned near due
Load horizon14 daysWindow for assignee load
Overload ratio1.2Load above which a member is overloaded
Severity thresholdsburn 1.25 / 1.75 / 2.5 · pressure 0.8 / 1.0 / 1.5Low / medium / high cut-offs (must ascend)
Notify project managersOnMaster switch for the daily alert
In-app bell · Email digestOnDelivery channels
Minimum severity to notifyMediumItems below it never alert
Auto-run AI advisorOffLet the daily job also ask AI (spends credits)

5. The admin contract​

  • Permissions: View risk radar (panel, badges, chips, AI advice); Manage risk radar (recompute, settings). Applying interventions uses the task permissions above.
  • Daily alerts are sent by the platform job Task Risk Radar Daily, which an operator enables per environment. Recipients are the project's managers and leads. An item alerts once when it appears and again only if it gets worse; an item that recovers stops alerting.
  • Credits: about 600 per interventions request (ceiling 2,400); nothing for the radar itself.

5b. Why is this at risk? — the explanation​

Figure 5 — Each item explains itself: the cause, the numbers behind it, and What to do next. 1 At-risk tasks, where the same explanation appears per task.

Every at-risk task, milestone and person now explains itself in plain English, right where the severity badge is:

  • a summary naming what is wrong and the number behind it
  • the other contributing signals, one line each
  • what to do next — a fixed, sensible step per signal
  • a 30-day score trend beside it, so you can see whether it is worsening or recovering

This is computed, not generated. It costs nothing, works when AI credits have run out, and cannot invent a figure — every number in it came from the engine.

Explain in detail is the optional paid second click: a longer narrative on that single item, grounded in the same facts plus its score history. It never proposes actions — ranked interventions remain the advisor's job. The free explanation stays on screen above it either way.


5c. Preview an intervention before applying it​

Beside Apply on any suggested intervention is Preview impact. It recomputes the entire risk picture with that change applied and shows you:

  • the project's severity and score, before → after
  • how many tasks are at risk, before → after
  • how each person's load moves
  • which individual tasks change verdict

Nothing is written. The engine's inputs are copied, the change is applied to the copy, and the result is recomputed. A split is labelled approximate, because dividing the remaining hours evenly is a guess about work nobody has broken down yet.

Reassign, extend, descope and split can be previewed. Unblock and escalate cannot — they post a comment, which changes nothing the engine measures.


5d. Applying an intervention is recorded​

Applying a suggestion goes through a server-side path that performs the same edit, re-checks the same permission a manual edit needs, and writes a line to the AI change ledger with the values before and after. So "an AI suggested this" is never lost, and the task's history is not just "a person edited a field".


6. Downstream​

  • Delivery forecast adds a P50/P80 finish date per milestone and the Forecast miss signal.
  • Portfolio risk rolls every project you are on into one page.
  • AI governance records every applied intervention.
  • Progress reports use the milestone health from the latest snapshot.
  • Applied interventions are ordinary task changes — they appear in the task's activity and notify as usual.

7. Don't confuse this with…​

  • Task analytics — describes what happened; the radar predicts what is about to.
  • Service Desk SLAs — measure response and resolution times on tickets, not delivery risk on tasks.
  • Plan with AI — creates work; the radar watches it.

8. Troubleshooting​

SymptomCauseFix
The explanation is missing on a rowThe stored snapshot predates Wave 3Press Recompute — explanations are computed on read from the stored signals
"Preview impact" is absentThat verb changes nothing the engine measures (unblock, escalate)Expected
No Risk buttonNo project selected, or you lack View risk radarPick a project; ask for the permission
Radar says "computed at" yesterdayThe daily job ran; nothing recomputed sincePress Recompute (Manage risk radar)
A task is stale but should not beStale after is too short for your cadenceRaise it in Project settings → Risk Radar
Everyone is "overloaded"Daily capacity is lower than reality, or estimates are inflatedAdjust capacity or the overload ratio
No daily emailsThe platform job is disabled, or notifications are off for the projectAsk your administrator; check the Notifications settings
"cached" advice after changesThe picture has not been recomputedRecompute, then ask again
